All County, All the Time Since 2010 MAKE THIS YOUR PRINCE EDWARD COUNTY HOME...PAGE!  Friday, April 19th, 2024

Picton Main Street open for summer beginning July 1

Main-Street-MakeoverThe County will be providing weekly ‘Picton Main Street Makeover’ construction updates to outline what work will be taking place and in what sections of Main Street. These updates are to help prepare businesses and residents for the upcoming work, and ensure that they have the most up-to-date information essential for planning their day-to-day activities.

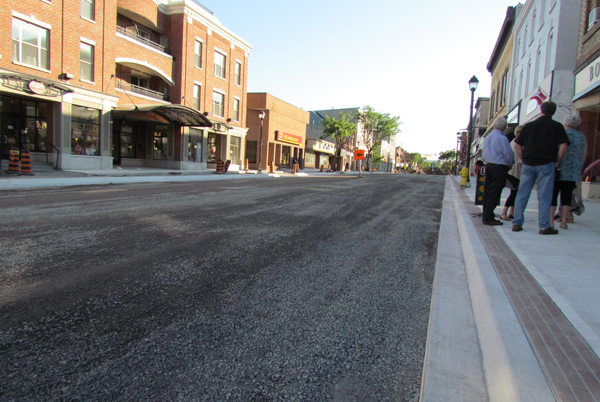

downtown-june-24

Here’s what construction work is happening starting June 27th …

Construction Summer Break Update: ALL of Picton Main Street (road and sidewalks) will be open starting Friday, July 1st, and no construction work will take place until September 6th, 2016.

Starting Wednesday, June 29th, Coco Paving will be begin to place asphalt on the first section of Main Street. Asphalt on the second section of Main Street (Ross Street to Elizabeth Street) will be done either the same day or on Thursday, June 30th. Line painting will be completed on Thursday.

For the second section of Main Street (Ross Street to Elizabeth Street) underground work will stop in an “as-is” state. Asphalt will be placed on the road and sidewalks that have had the concrete removed, and no construction work will take place on Main Street until after Labour Day weekend. Buildings in this section will remain on temporary water lines for July and August. Taggart Construction Ltd. will be delivering notices to each building with instruction on who to contact should you have water issues over the summer months.

The installation of the new watermain and sanitary services is now complete between Ross Street and Elizabeth Street.

Sidewalks will continue to be poured to complete the sidewalk on the South-side of Main Street between Bridge and Ross Streets.
This installation process will involve pouring the first panel of the sidewalk (the portion closest to the building), and then later the curbside will be installed, followed by the middle panel once the water/sewer tie-ins have been completed.

Taggart Construction crews continue to work 7AM to 7PM and on Saturdays.

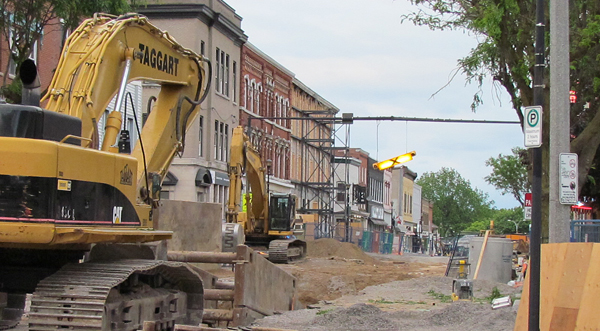

Main-Street-June



Here’s what construction work is happening starting June 20th …

Buildings on Main Street between Bridge Street and Ross Street will have watermain tie-ins completed once the main watermain has required testing approved. These connections may begin this week and will start at William Street and then move East along Main Street.

The installation of the new watermain and sanitary services will continue moving West on Main Street from Ross Street to Elizabeth Street.

Sidewalks will continue to be poured on the South-side of Main Street between Bridge and Ross Streets.
This installation process will involve pouring the first panel of the sidewalk (the portion closest to the building), and then later the curbside will be installed, followed by the middle panel once the water/sewer tie-ins have been completed.

Construction Shutdown Update: it is anticipated that during the last week of June the first section of Main Street (Bridge Street to Ross Street) will be paved and be open to vehicle traffic by July 2nd. The second section of Main Street (Ross Street to Elizabeth Street) will be paved once the sidewalk curbs have been installed to allow for asphalt paving.

Taggart Construction crews continue to work 7AM to 7PM and on Saturdays.

Temporary stop signs are in place in both directions on Mary Street at the intersection of Elizabeth Street for the duration of the construction project. This new all-way stop signs intersection is in place to allow for safe pedestrian crossing from the Mary Street parking lot.

Here’s what construction work is happening starting June 13th …

All buildings on Main Street between Ross Street and Elizabeth Street are now connected to the temporary water line.

Buildings on Main Street between Bridge Street and Ross Street will have watermain tie-ins completed once the main watermain has required testing approved. These connections may begin this week and will start at William Street and then move east along Main Street.

The installation of the new watermain and sanitary services will begin moving west on Main Street from Ross Street to Elizabeth Street.

Sidewalks will begin to be poured on the south-side of Main Street between Bridge and Ross Streets.
This installation process will involve pouring the first panel of the sidewalk (the portion closest to the building), and then later the curbside will be installed, followed by the middle panel.
When the first panel is being installed, businesses will continue to have access to their stores as ramps will be built to accommodate pedestrians. Businesses will not need to be closed during this process.
With sidewalk installations we advise that the sidewalks are not used or disturbed for at least 24 hours, including the time after which the new sidewalks are sprayed white.
Taggart Construction crews continue to work 7AM to 7PM and on Saturdays.

Temporary stop signs will be placed in both directions on Mary Street at the intersection of Elizabeth Street for the duration of the construction project. This new all-way stop signs intersection is in place to allow for safe pedestrian crossing from the Mary Street parking lot.

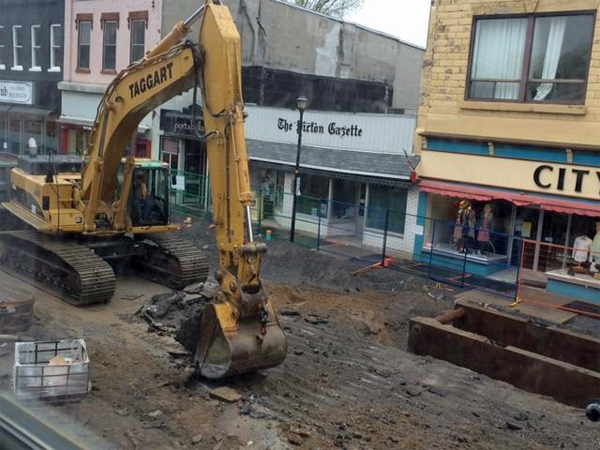

Picton-Main-construction-may-2016

Here’s what construction work is happening starting June 6th …

The temporary watermain is now in place along Main Street between Elizabeth and Ross Streets. A plumber may be visiting properties to make the switch from the main line to the new temporary line.

Sidewalks will begin to be poured on the North-side of Main Street between Bridge and Ross Streets.
This installation process will involve pouring the first panel of the sidewalk (the portion closest to the building), and then later the curbside will be installed, followed by the middle panel.
When the first panel is being installed, businesses will continue to have access to their stores as ramps will be built to accommodate pedestrians. Businesses will not need to be closed during this process.

Cogeco is installing Fibre Optics along Main Street, which will offer enhanced services and opportunities for the businesses within the downtown area.

Here’s what construction work is happening starting May 30th…

Roto-Milling is scheduled to begin Monday on Main Street from Ross Street to Elizabeth Street.
Taggart Construction will spend the better part of next week finalizing all new service line hookups
Elizabeth street water tie-in’s will begin this upcoming week
Taggart Construction is installing new starburst signs that indicate that new traffic lights are in the area.
The streetlight out front of Shire Hall will be fully functional by the end of the business week.

Here’s what construction work is happening starting May 24th…

There will be NO CONSTRUCTION ON MONDAY, MAY 24th.

Taggart Construction will be continuing to make temporary water main connections to businesses along the North side of Main Street moving from east to west between Ross Street and Elizabeth Street starting Tuesday, May 24.
Notices from Taggart Construction will be delivering notices to the impacted businesses detailing when the water connections will be made for each property on Tuesday, May 24 and Wednesday, May 25.
Water service will be temporarily interrupted when the connections are being made. Businesses should contact Dave Hinchliffe (see contact information below) if their operations are sensitive to the timing of the interruption, so that this can be coordinated within the schedule.
Isolated excavations will occur within the sidewalk on the North side of Main Street as part of the installation of the water service laterals.
There will be minor lane and parking restrictions along Main Street (North side) during this process.

Taggart will continue to do construction work on the sidewalks along the North side of Main Street moving from east to west between Bridge Street and Ross Street.
Work will be done in front of one building at a time and will involve removing the curb and part of the sidewalk closest to the building. Once replaced, the middle panel of the sidewalk will be remove for utility installation.
When sidewalks are being removed in front of a building, there will be limited/no access to the building for a short period of time.
Taggart will schedule this work to take place in the morning, and have access to the buildings by 11am.

No parking will be permitted at 55 King Street on Tuesday, May 24. The parking lot will be available on Wednesday, May 25.

Temporary traffic lights will be active at the intersections of Bridge St. and Union St., and Paul St. and Main St.

Construction takes place between 7am and 7pm on week days.

Friendly Reminders…

Taggart Construction will continue to bring garbage bags from individual properties to a central location for pick-up. Please ensure that your garbage bags have a tag on it to ensure that it will be picked up by collection services.

Businesses looking for free long-stay parking can use the new municipal parking lot available at 55 King Street, with the exception of Tuesday, May 24.

Here’s what construction work is happening starting May 16th…

Taggart Construction will be making temporary water main connections to businesses along the North side of Main Street moving from east to west between Ross Street and Elizabeth Street starting Wednesday, May 18.

Water service will be temporarily interrupted when the connections are being made. Businesses should contact Dave Hinchliffe (see contact information below) if their operations are sensitive to the timing of the interruption, so that this can be coordinated within the schedule.
Isolated excavations will occur within the sidewalk on the North side of Main Street as part of the installation of the water service laterals.
Taggart Construction has delivered notices to the impacted businesses detailing when the water connections will be made for each property.
There will be minor lane and parking restrictions along Main Street (North side) during this process.

Taggart will begin to do construction work on the sidewalks along the North side of Main Street moving from east to west between Bridge Street and Ross Street.

Work will be done in front of one building at a time and will involve removing the curb and part of the sidewalk closest to the building. Once replaced, the middle panel of the sidewalk will be remove for utility installation.

When sidewalks are being removed in front of a building, there will be limited/no access to the building for a short period of time.
Taggart will schedule this work to take place in the morning, and have access to the buildings by 11AM.

Temporary traffic lights will be installed at the intersections of Bridge St. and Union St., and Paul St. and Main St. These lights will be active for the duration of construction and will be operational by Friday, May 20.

Construction takes place between 7AM and 7PM on week days. There will be no construction on Monday, May 23.

Here’s what construction work is happening starting May 7th…

Taggart Construction will be making a temporary water main connection to the Canada Post Office on Saturday May 7:
An isolated excavation will occur within the sidewalk that will block access to the front entrance of the building, as part of the installation of the water service lateral. There will be access to the parking lot at the back of the building through the East side.
Access to the front entrance will be available after noon that same day.

There will be a final excavation of the roadway at the intersection of Bridge Street and Main Street (top of the town hill) on Monday, May 9th for the duration of the day. A flag person will be on site to direct traffic flow.

Temporary traffic lights will be installed at the intersections of Bridge St. and Union St., and Paul St. and Main St. These lights will be active for the duration of construction and will be operational within the next 1-2 weeks.

Picton Library Launches Kids Construction Zone

Visit the Picton Library on Saturday, May 7th for the safety tape cutting at noon to launch their kids construction zone. The zone was created to educate children about construction and allow them to experience hands-on activities related to construction work.

The zone has created in part by donations and support from: Taggart Construction Ltd., Greer Galloway Consulting Engineers, Terra Vista Landscape Firm, and Picton Home Hardware.

Here’s what construction work is happening starting May 2nd:

Taggart Construction will be continuing to make temporary water main connections to businesses along the South side of Main Street moving from east to west.
Water service will be temporarily interrupted when the connections are being made. Businesses should contact Dave Hinchliffe (see contact information below) if their operations are sensitive to the timing of the interruption, so that this can be coordinated within the schedule.
Isolated excavations will occur within the sidewalk on the South side of Main Street as part of the installation of the water service laterals.
Taggart Construction has delivered notices to the impacted businesses detailing when the water connections will be made for each property.

There will be a second excavation of the roadway at the intersection of Bridge Street and Main Street (top of the town hill) on Monday and Tuesday (May 2 & 3). A flag person will be on site to direct traffic flow.

Temporary traffic lights will be installed at the intersections of Bridge St. and Union St., and Paul St. and Main St. These lights will be active for the duration of construction.

Friendly Reminders…

Taggart Construction will continue to bring garbage bags from individual properties to a central location for pick-up. Please ensure that your garbage bags have a tag on it to ensure that it will be picked up by collection services.

Businesses looking for free long-stay parking can use the new municipal parking lot available at 55 King Street.

Click here, or the Main Street Makeover logo, for more details on the project.

Here’s what construction work is happening starting April 25th:

On Monday, April 25 Taggart Construction will begin making temporary water main connections to businesses along the south side of Main Street moving from east to west.

Water service will be temporarily interrupted when the connections are being made. Businesses should contact Dave Hinchliffe (see contact information below) if their operations are sensitive to the timing of the interruption, so that this can be coordinated within the schedule.

Isolated excavations will occur within the sidewalk on the South side of Main Street as part of the installation of the water service laterals.

Taggart Construction has delivered notices to the impacted businesses detailing when the water connections will be made for each property.

There will be excavation of the roadway at the intersection of Bridge Street and Main Street (top of the town hill) beginning as early as next Thursday. Two-way traffic flow at this location will be maintained, but some larger truck traffic may be redirected along detour routes.



Here’s what construction work is happening starting April 18th:

Temporary water will soon be connected to the municipal line. Starting as early as Tuesday, April 19th, Taggart Construction will start to do connections to businesses.

Water service will be temporarily interrupted when the connections are being made. Businesses should contact Dave Hinchliffe or Robert Ross (see contact information below) if their operations are sensitive to the timing of the interruption, so that this can be co-ordinated within the schedule.

Starting on the North side of Main Street isolated excavations will occur within the sidewalk area as part of the installation of the water service laterals.

Taggart Construction will be delivering notices to the impacted businesses for when water connections will be made.

For more information about the project, visit www.thecounty.ca and click on the Picton Main Street Makeover logo.

Need assistance or have further questions?

For CONSTRUCTION inquiries: (i.e. access to buildings, deliveries, parking)
Project Engineer:
Matthew McIntosh
Project Manager
Greer Galloway Consulting Engineers
613.966.3068 x336
mmcintosh@greergalloway.com

Project Contractor:
Justin Haight
Project Manager and Communications
c: 613.561.8149
o: 613.389.7550 x227
jhaight@taggartconstruction.com

ON-SITE Assistance (for businesses and residents within the construction area)
Robert Ross
On-Site Superintendent
c: 613.536.9973
rross@taggartconstruction.com

Dave Hinchliffe
On-Site Foreman
c. 613.536.9977

EXTRA ASSISTANCE: Two workers with blue hardhats are available to assist within the construction zone for issues such as pedestrian assistance, delivery and pick-up assistance.
